Reduce Backlog and Rework in Engineering Service Operations

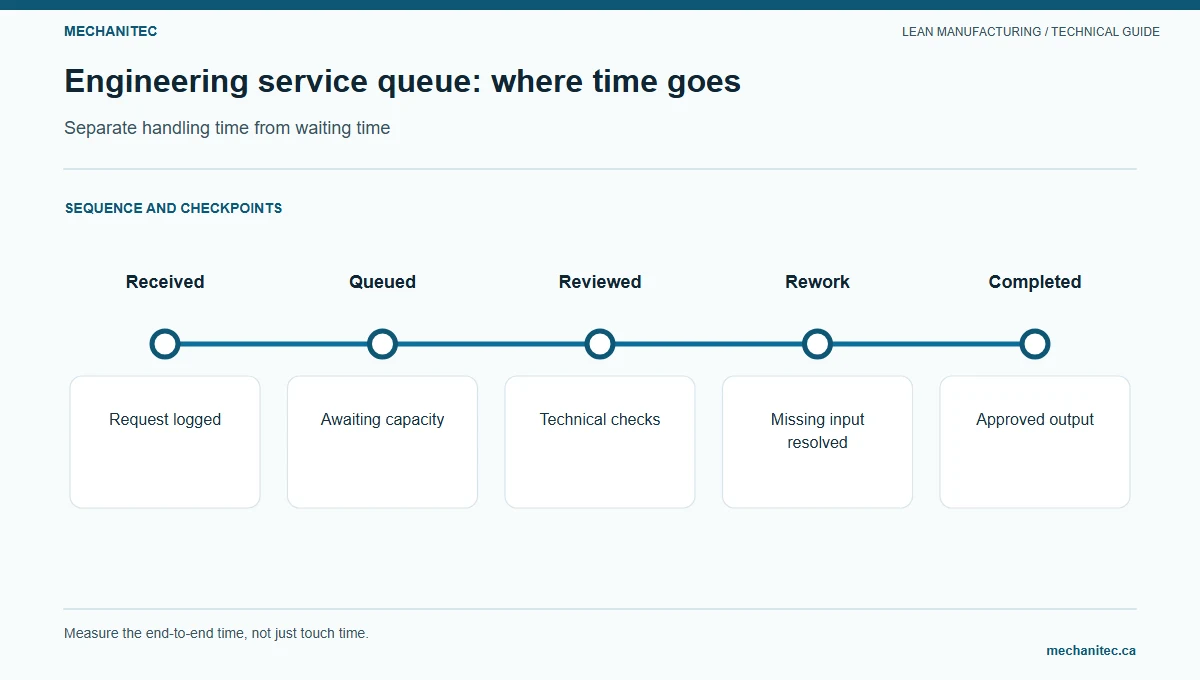

An engineering service team can keep every person busy while customers and internal users still wait. Work may stall because a request is incomplete, a specialist has too many active jobs, a reviewer is unavailable, or the team discovers a missing requirement late. The first decision is to map one request type from receipt through an accepted release and separate active work from queue time. Then choose one handoff problem to test without skipping engineering or quality review.

This guide covers accepted engineering requests such as drawing changes, inspection reports, design support, and internal technical responses. It focuses on the work queue and review handoffs. For quoting a prospective customer request before order acceptance, see the separate quote-to-order workflow guide.
Define the request and finish point
Choose one work family with a repeatable intake path. “Engineering requests” may include tasks with different skills, risk, and approvals. A drawing correction can differ from a new fixture design or a customer-facing deviation analysis. Group work only when the steps and acceptance rules are similar enough for a useful comparison.
Define the start event as the time an authorized request enters the team’s queue. Define the finish as the time an approved result is released to its intended recipient, with the current revision and next action clear. If the request can be canceled, returned for missing information, or redirected, record that outcome rather than deleting it from the sample.
For each request type, specify its minimum ready inputs: requestor and need, part or system identity, current revision, affected interface, requested date, acceptance criteria, supporting files, and required approver. Some fields may not apply to every job. The responsible engineer or quality owner should define the technical content, not a generic form. If a request is incomplete, ask a specific question and make the waiting state visible.
Separate “received” from “ready.” The clock from initial receipt shows the requestor’s full experience. The clock from ready status helps the team study the work after required inputs are present. Keep both. If the team reports only ready-to-release time, it can hide a slow intake clarification; if it reports only receipt-to-release time, it can blame engineering for time spent waiting on an external answer. The two measures make that distinction visible.
Use a small number of request classes that change the route or review requirements. For example, a controlled drawing revision may need document-control and manufacturing review, while an inspection report may use a defined measurement and approval path. Define who may assign the class and how a team corrects a misclassified request. Do not create a new class for every exception; record the exception reason so the team can see whether the standard routes still fit.
Map five common obstacles to a response
A value-stream map includes the information and work needed to deliver an outcome across multiple steps. Lean Enterprise Institute recommends mapping the current state from actual observation before drawing a future state. For engineering services, include request information, work ownership, review decisions, and release control. A forwarded email does not complete a handoff; the next owner needs the right inputs and a clear decision to make.
| Observed trigger | Root-cause hypothesis to check | First owner | Safe response or escalation | Evidence to record |
|---|---|---|---|---|
| Request waits for basic details | Intake does not state the required revision, interface, or acceptance condition | Request owner with the receiving engineer | Ask for the exact missing input; retain the request in an “awaiting input” state | Receipt time, question time, answer time, and missing field |
| One specialist owns many active jobs | Work is released faster than available skill capacity or tasks are interrupted | Engineering supervisor | Review active count by skill and agree which request is next; route urgent exceptions through the authorized owner | Active work count, priority changes, interruptions, and displaced work |
| Review queue grows | Review starts only at large batches or packages arrive incomplete | Authorized reviewer and team lead | Check review-ready criteria and test a short scheduled review slot if capacity permits | Review-ready time, review start, comments, and release decision |
| Blocked work has no next action | “On hold” hides who must decide or when to update the requestor | Current request owner | Name the blocker owner, next action, and update date; escalate when the agreed threshold is reached | Block start, reason, owner, next update, and resolution time |
| Repeated revision loops | Inputs, assumptions, interface conditions, or acceptance checks are not aligned before review | Request owner and technical lead | Classify comments and verify the controlled revision; do not bypass approval to reduce cycle time | Revision count, reason, source of change, and first-pass acceptance |
These are hypotheses, not a universal list of Lean problems. Ask the requestor, engineer, reviewer, and release recipient to walk through a real example. Check the records before assigning a cause. A queue may be appropriate when it protects specialist capacity, separates a safety review, or awaits information that the team cannot supply.
Separate touch time from waiting time
For each request, capture receipt, ready-for-work, engineering start, review-ready, review start, rework return, customer or internal clarification, release, and cancellation timestamps where they apply. Use a consistent staffed-hours calendar. Record active handling time separately from elapsed queue time. Do not subtract a waiting period from the overall elapsed measure; show its cause as a separate component so the team can see where the delay occurred.
Choose measures that match the work: elapsed time from ready request to accepted release, time waiting for missing inputs, reviewer queue age, active requests by skill, revision loops, first-pass review acceptance, and urgent interruptions. State the request type, period, count, and whether canceled or still-open requests are included. A mean alone can hide a few old jobs, so show the median and an aging list or distribution when the sample permits.
Review an illustrative five-request queue
Illustrative example — five invented engineering support requests; not measured company performance: business hours count only hours when the team is scheduled to work. Day 0 marks receipt. The log gives elapsed business hours from receipt to release, active touch hours, and the main wait or rework observation. It does not treat nights or closed days as staffed time.
| Request | Ready (business hour) | Engineering starts | Review starts | Clarification or rework | Released | Elapsed business hours | Touch hours | Main wait or rework |
|---|---|---|---|---|---|---|---|---|
| ER-01 | 1 | 2 | 5 | None | 9 | 9 | 2.0 | Routine reviewer queue |
| ER-02 | 4 | 10 | 22 | Clarification returned at hour 40 | 50 | 50 | 3.5 | Input wait and one review loop |
| ER-03 | 2 | 8 | 16 | None | 40 | 40 | 4.0 | Reviewer capacity |
| ER-04 | 2 | 6 | 10 | Two comment loops; final check at hour 24 | 32 | 32 | 6.0 | Assumptions not aligned before review |
| ER-05 | 16 | 24 | 32 | Internal clarification returned at hour 48 | 64 | 64 | 5.0 | Incomplete intake, then approval wait |
The five elapsed times sort to 9, 32, 40, 50, and 64 business hours. The median is 40 hours. The mean is 39 hours: (9 + 50 + 40 + 32 + 64) ÷ 5 = 195 ÷ 5. The recorded touch time totals 20.5 hours. These are separate quantities: 39 hours is average elapsed staffed time from receipt to release across five hypothetical requests; 20.5 hours is the sum of hands-on estimates. Do not divide or compare the totals as if they measured the same thing.
In a real queue, investigate the oldest requests first. Confirm the current status, owner, due date, actual block, and next update. Do not restart a clock to make an aging item appear new. If a request changes scope, keep the original receipt record and record the new revision or work authorization under the team’s document-control rules.
Use a blocker board with clear ownership
A simple board should let the team answer “what is waiting, why, and who acts next?” Keep controlled drawings, confidential customer data, and approval records in their authorized systems. The board can use an ID and a secure link rather than copying sensitive content.
| Field | Entry rule |
|---|---|
| Request ID and work type | Use the controlled ID and one defined service family. |
| Receipt and ready times | Record original receipt and when minimum inputs are complete. |
| Current stage and stage-entry time | Show the active step and how long the item has waited there. |
| Next action and owner | Name one action and the person or role responsible. |
| Blocker and start time | Use a specific reason such as “awaiting interface drawing,” not just “on hold.” |
| Due date and priority reason | Keep the approved commitment and exception basis visible. |
| Review status and revision | Identify the controlled version and whether the package is review-ready. |
| Release and next recipient | Record authorization, distribution, and confirmation of the handoff. |
At a short daily or agreed-frequency review, check overdue and blocked work, assign a next action, and resolve missing ownership. Then check new requests and skill capacity. Avoid treating every request as equally urgent. If the team sets a limit on active work, make clear who may authorize an exception and what existing work will pause. A limit should reveal overload, not hide demand.
Handle priority and technical risk explicitly
Some work must move ahead because a safety, quality, regulatory, or customer requirement sets its timing. The authorized owner should record the reason, affected commitments, and work displaced. A visual board does not grant engineering approval. Preserve design review, hazard analysis, calculations, customer-specific requirements, verification, document control, and release authority as applicable.
Do not use a single first-in, first-out queue when requests require different skills or when risk controls dictate an order. Route work by qualification while keeping its age and owner visible. If a team is overloaded, escalate the capacity decision rather than concealing the delay with overtime, task switching, or incomplete review.
The U.S. EPA’s Lean waste reference identifies service examples such as design or engineering errors, response-time waiting, approval delays, and repeated data entry. These examples can guide observation, but the team must determine whether a particular step is necessary. A review that prevents an incorrect release is not removed merely because it adds elapsed time.
Run a bounded improvement test
- Select one request type and review a small set of recent records with the people who perform the work.
- Map receipt, readiness, engineering, review, rework, and release using actual timestamps.
- Choose the largest verified queue or repeat defect and state a cause hypothesis.
- Assign a supervisor or technical owner and define how urgent work will be escalated.
- Test one change, such as a request-ready checklist or a scheduled review slot.
- Compare elapsed time, queue age, revision loops, and first-pass acceptance using the same definitions.
- Keep the change only if technical review and release controls remain effective.
For the flow of design work and dependency management during product development, see the engineering product-development guide. For CAD change control from released drawing to shop-floor use, see the engineering change workflow.
