Home » Addressing the Challenge of Communication in Lean Implementation

Improve Shop-Floor Handoffs During Lean Implementation

When a job waits because the next person does not know its status, make the handoff visible and assign a clear escalation owner. A daily huddle works only when it connects a real signal to an action, deadline, and follow-up. This guide gives you a short huddle routine, a handoff record, and a press-brake example using illustrative data.

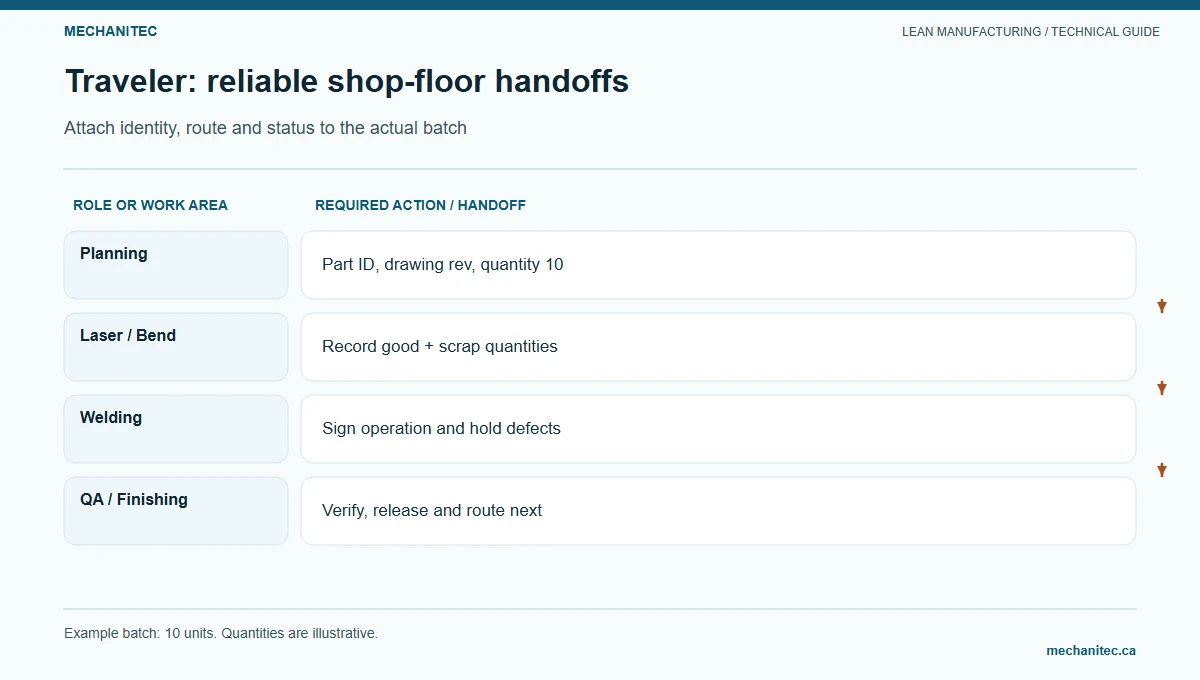

Traveler: reliable shop-floor handoffs. Attach identity, route and status to the actual batch. Mechanitec instructional diagram.
Attach identity, route and status to the actual batch. Mechanitec instructional diagram.

Use a five-minute huddle to resolve work barriers

Meet at the cell board at a consistent shift time. Keep customer-sensitive drawings and personal data off a public board. Review the next work, current constraint, overdue jobs, shortages, quality holds, maintenance issues, and help requests. The operator identifies the condition; the leader confirms the owner and when the team will receive an update.

Daily huddle agenda and required output
Minutes Question Output
0–1 Is anyone or any job in an unsafe or uncontrolled condition? Immediate stop and approved escalation when needed
1–2 What work is due next, and is the packet, material, and revision ready? Agreed sequence or named readiness gap
2–3 Which job is blocked and why? One reason code, job reference, and responsible function
3–4 What decision or support is required? Owner, due time, and escalation point
4–5 What changed since the last huddle? Closed items removed; unresolved items carried forward with status

The huddle is not a substitute for a detailed problem-solving session. Move complex root-cause work to a small team with the right expertise and records. Return a concise status to the board so the next shift knows what changed.

Make the handoff record specific

Reusable handoff fields for a fabrication job
Field Example entry
Job and operation Job EX-104, operation 30, press brake (illustrative identifier)
Current state Waiting; no machine setup started
Verified reason Traveler references revision B; controlled drawing now revision C
Immediate control Job held in the designated location; no forming until authorization
Owner and next action Engineering confirms the applicable revision; planner updates the packet
Update due Before the next scheduled release review
Closure evidence Authorized packet and revision checked by the receiving operator

This is an example of a communication record, not a real incident. Follow the site’s controlled document, quality-hold, and engineering-change procedures. A board status never authorizes work against an unverified drawing or substitutes for a formal nonconformance record.

Define escalation by condition and response

  • Safety concern: stop or secure work under the site’s safety procedure and contact the designated supervisor immediately.
  • Quality hold or revision conflict: identify and contain affected work; contact the authorized quality or engineering owner.
  • Material shortage: planner checks inventory and supplier status; do not substitute material without authorization.
  • Equipment interruption: operator uses the defined help signal; maintenance acknowledges, responds, and records the reason and restoration time.
  • Schedule conflict: planner and supervisor confirm priority using customer commitments and available capacity.

Set response-time expectations by risk and operating needs. Measure elapsed time from signal to acknowledgement and from acknowledgement to resolution; do not call a signal “effective” merely because it was displayed.

30-day communication improvement test

Illustrative pilot for improving shift-to-shift handoffs
Week Test Measure Owner
1 Observe handoffs on all shifts and classify missed information Count incomplete handoffs by verified reason Supervisor and operators
2 Trial the shared handoff fields on one cell Required fields completed; stale or duplicate items Cell lead
3 Add owner and due-time rules for blocked jobs Time to acknowledgement and overdue unresolved items Process owner
4 Review with each shift; adjust or stop the format Repeat incidents, rework from information errors, and user feedback Operations manager

Compare the same definitions before and after the trial. Keep sample counts and job mix with the results. If the board increases duplicate entry or hides work from the controlled system, simplify it or stop the trial.

For an escalation signal specification, see the manufacturing Andon guide. For the broader pilot sequence, use the Lean implementation guide.

Build the handoff around a real lot

Use a traveler that follows the part, whether the shop uses paper, a barcode, or a controlled production system. At minimum, identify the job, part number, revision, released quantity, completed quantity, rejected quantity, process route, current status, hold tag, inspector when required, and authorization to move. The traveler is a status record; it does not replace the controlled drawing, inspection plan, or formal nonconformance process. The operator records the event at the point it occurs so the next person does not have to infer whether a cart is waiting, accepted, or blocked.

Consider a fictional lot of ten sheet-metal brackets moving from laser cutting to a press brake, welding, coating, and final inspection. After bending, nine pieces meet the checked requirement and one has a dimensional concern. The operator records ten started, nine accepted at this step, zero scrapped, and one held. The physical pieces are separated into a clearly identified accepted container and a controlled hold location. The traveler and system show the same quantities and status before the accepted work moves. The example describes a communication control, not a quality disposition: only the authorized quality process can decide whether the held piece is reworked, accepted by concession, or scrapped.

Illustrative lot status at the press-brake handoff
Record field Example entry Handoff check
Job, part, revision J-104 / bracket / Rev C Matches the controlled job packet.
Quantity released / completed 10 / 10 at bending Count physical pieces before moving the cart.
Accepted / rejected / held 9 / 0 / 1 9 + 0 + 1 = 10; do not count a hold as accepted.
Current and next process Brake complete / weld next Confirm the next operation has capacity and current instructions.
Hold reference / move authorization NCR-___ / accepted container only Keep the held piece identified; follow the site’s authorization rule.

Before release, the sender and receiver reconcile quantities and status. If the downstream process can accept only nine pieces, the record must make that partial release explicit. If the shop requires a complete lot, the nine accepted pieces remain in the designated queue until the authorized disposition is known. A count discrepancy stops the handoff while the team reconciles the traveler, physical containers, and system record. Never “fix” the count by editing a record without identifying the source of the mismatch.

Make status changes visible across shifts

Agree on a small set of states that match the actual workflow: not released, ready, in process, awaiting inspection, accepted, held, and complete are common candidates, but the site’s process owner must select the valid states. Define who may change each state and what evidence is required. A red tag or other hold indicator must identify the affected part and lot, reason or nonconformance reference, person or role to contact, and date. Use approved colors and labels consistently; color alone is not a control because people may not distinguish it or may see it out of context.

At shift end, the outgoing operator lists unfinished jobs, current operation, quantity by status, open hold reference, next expected event, and any response already requested. The incoming operator checks the physical work and the record, then acknowledges gaps. “Waiting on material” is not enough: include the part, purchase order or shortage reference if available, who owns the next response, and when the team will check again. This creates a recoverable handoff when the person who raised the issue is no longer on shift.

For an abnormality, define a response sequence before the pilot. The operator protects the product and people, records the condition, and contacts the named role. The supervisor confirms containment and assigns the next owner. Quality or engineering decides technical disposition within its authority. The next operation receives a clear status update when the constraint changes. Escalation means getting the right decision; it does not authorize an operator to bypass inspection, drawing revision, or process approval.

Audit communication quality with observable evidence

For two weeks, sample a small number of handoffs at each shift change. Check whether the record identifies the job and revision, whether accepted and held quantities reconcile, whether the physical status matches the record, whether the next owner is named, and whether open issues have a review time. Record misses by type and process step rather than grading workers. If the same field is repeatedly blank, examine the form, system sequence, training, and workload before adding another reminder.

A useful communication measure is the share of sampled handoffs with complete required fields: complete handoffs ÷ handoffs reviewed × 100. If 18 of 20 fictional samples pass, the result is 90%; keep the count and sample rule beside the percentage. Track wrong-revision starts, quantity discrepancies, and time from escalation to acknowledgement separately. These measures answer different questions and should not be blended into one score. A lower number of handoff errors is not proof that the process is better if the team has stopped recording them.

Test the change without disrupting controlled work

Choose one route and one shift for the initial communication test. Obtain approval from production control, quality, and the system owner if the change touches controlled records. Train the users with a real but closed example, observe the first handoffs, and capture defects in the form or instructions. Do not change a required traveler field, electronic status, or inspection release rule without the responsible process owner’s authorization. Expand only when the record remains understandable during interruptions, split lots, holds, rework, and shift changes.

Stop and revise the test if the new form causes duplicate records, hides partial quantities, permits a held piece to travel as accepted, or creates an unclear owner. A short huddle can surface the issue, but the controlled record must preserve the decision. Keep one version of the form, identify its owner and revision, and remove obsolete copies through the site’s document-control process.

Use escalation rules that name the decision owner

Write escalation triggers in terms of an observable condition and response deadline. The exact response time depends on customer risk, process pace, and site rules; the following example is a template to adapt, not a universal service-level promise.

Example handoff escalation matrix for a controlled production route
Condition Immediate control Decision owner Record and return message
Revision on traveler does not match controlled drawing Pause affected work and identify any potentially affected pieces. Engineering/document control with quality as required Record job, part, revisions checked, affected quantity, and authorized release decision.
Accepted, held, and physical counts do not reconcile Keep the lot in its current controlled location. Area supervisor and quality or inventory owner Recount with a second person and correct the source record with traceable reason.
Downstream operation cannot take the released quantity Keep the remaining pieces identified and visible in the queue. Production control or designated scheduler State the quantity accepted, next capacity window, and next review time.
Safety concern or uncertain hold status Follow the site urgent hazard or product-containment process. Qualified safety or quality role Use approved reporting system; do not wait for a routine huddle.

After the issue is resolved, tell the sender and receiver what changed, who authorized the decision, and which record now contains the disposition. A verbal update without a matching controlled status can leave the next shift with two conflicting versions. The supervisor checks the system after the handoff and follows up on any open decision at the named review time.

Source
